Earned Value Management

Earned Value Management is an objective method by which a project’s progress with respect to schedule and cost can be tracked and the time/cost required to complete the project can be estimated.

The details are explained in the sections below.

EVM Terms (and their Notation, Unit and Description)

TermNotationFormulaUnitDescription
Budget at CompletionBAC$ or Person-MonthsThe original total budget for the project.
Planned ValuePV$ or Person-MonthsTotal portion of the approved total budget that is planned to be spent on an activity till date.
Actual CostAC$ or Person-MonthsTotal costs incurred in accomplishing work till date
Cumulative % of Total Work Completed Till datePWCSpecify total size of each task in suitable units. Eg. # Test Cases Executed for Test Execution Task.
PWC = Sum_of_Size_of_tasks_completed_till_date / Total_size_all_tasks_in_the_project
%
Earned ValueEVPWC * BAC$ or Person-MonthsAn estimate of the value of the actual work that is completed till date.
Cost VarianceCVEV – AC$ or Person-MonthsDifference between EV and AC ie (CV = EV-AC)
Schedule VarianceSVEV – PV$ or Person-MonthsDifference between EV and AC ie (SV = EV-PV)
Cost Performance IndexCPIEV/AC%Ratio of EV to AC
Schedule Performance IndexSPIEV/PV%Ratio of EV to PV
Estimate at completion (Estimated cost at completion)EACBAC/CPI (or)

BAC/(EV/AC) (or)

BAC * (AC/EV)
$ or Person-MonthsEstimated cost at completion assuming current performance continues into future.
Explanation: EV -> AC; => 1 -> AC/EV; ==> BAC -> BAC* (AC/EV);
Estimate time to completeETCOriginal Duration/SPIMonthsEstimated total time to complete assuming current performance continues into future

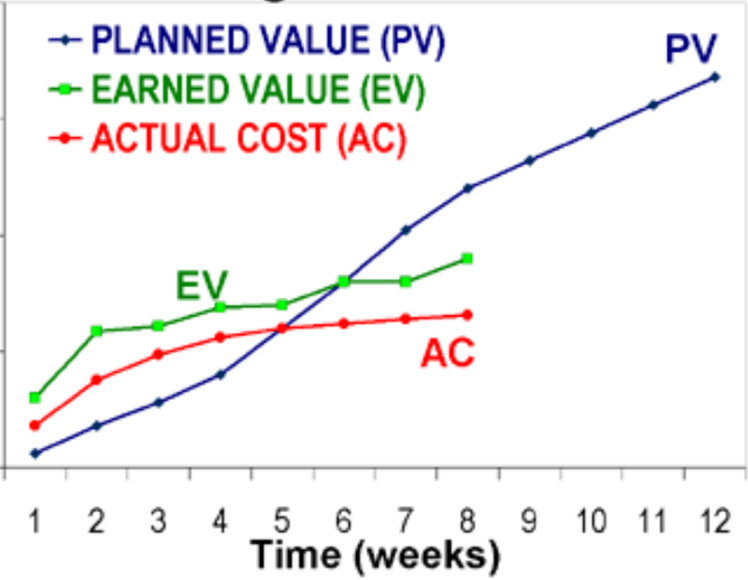

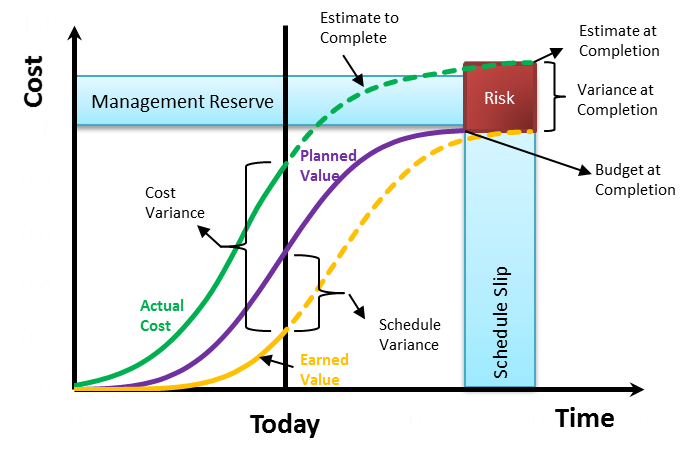

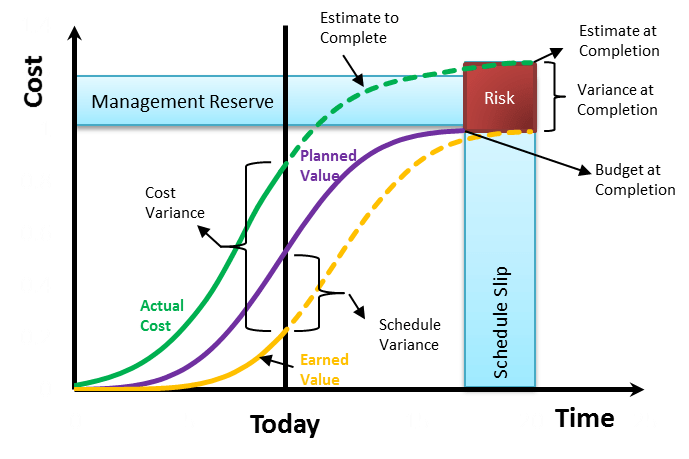

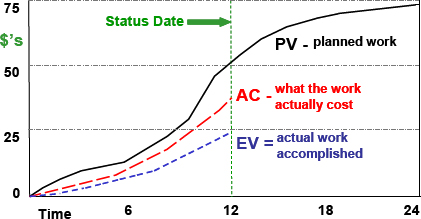

EVM Illustrations:

https://en.wikipedia.org/wiki/Earned_value_management
https://www.pmi.org/learning/library/make-earned-value-work-project-6001
https://www.linkedin.com/pulse/earned-value-management-powerful-tool-project-liaqat-pmp-ccp-fsa-/

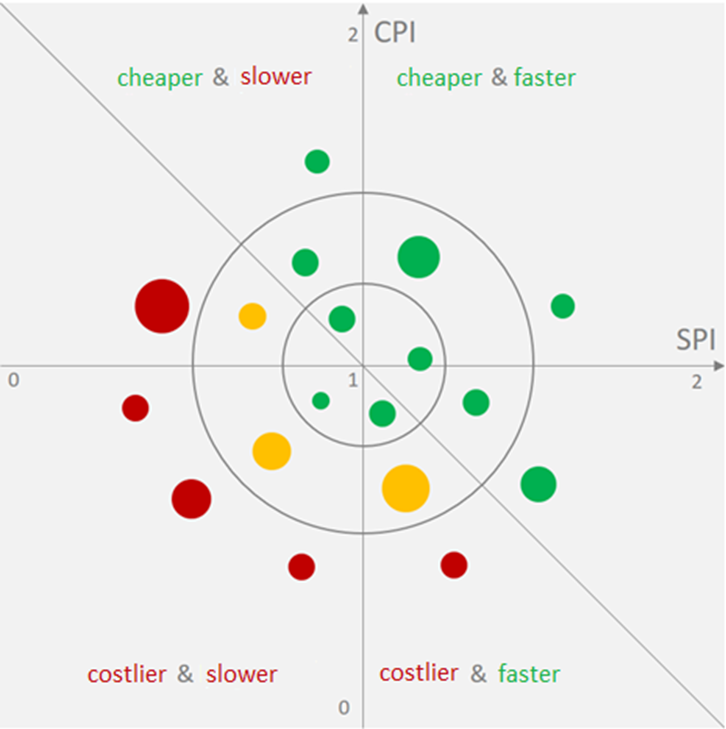

Below is an illustration of using CPI and SPI to know the summary status of various projects. The size of the bubble could be based on one parameter and colour could indicate some other parameter.
